The following is a list of upcoming and ongoing construction projects and road closures.
To apply for a road closure or right of way occupancy request, please see Applications, Licenses and Permits.
To receive regular updates on upcoming and ongoing construction projects, click "Receive email updates" at the bottom of this page.
Upcoming and Ongoing Construction Projects
Wellington Street Reconstruction - Ongoing |
About the project |
Procurement: Tendered
Contractor: Lavis Contracting
Cost: $2.375 million
Project area:
- Wellington St. N - Wellington St. Bridge to Queen St. E
- Wellington St. S - Queen St. E to 152 Wellington St. S

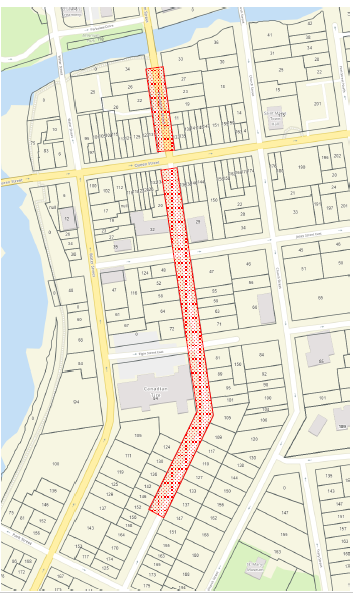

View a project area map.
|
Work schedule |
Start date
March 2022
Project length
Approximately 18 weeks
|
Project objectives |
Watermain replacement
- Replace and upsize watermain between north of Queen St. to Wellington Bridge for creation of redundant large feed to the north
- Replacement of legacy copper water services from street watermain into commercial building basements or residential property lines
Storm sewer replacement
- Improve drainage with grading and new storm sewers/catch basins where necessary
Sanitary
- Targeted sanitary repairs
Sidewalk curb and gutter replacements/improvements
Asphalt road replacement
- Replace deteriorated asphalt roadway
Other utility improvements
- Upgrade gas mains
- Correct streetlight grounding issue
- Add stamped concrete boulevard from Jones St. to bridge
- Improve hydrant placement
- Add parking to both sides of street (Elgin St. to bridge)
|
Project updates |
Latest update - June 23, 2022
Wellington Street paving
A base coat of asphalt will be applied to Phase 1 of the Wellington Street reconstruction area on June 24, 2022 (south end of Wellington Street to the Foodland entrance). The topcoat will be added in the fall.
Residents are asked to stay off the new asphalt until after the contractor has moved their equipment offsite at the end of the working day. Residents will then have access to driveways until the concrete subcontractor returns to form and pour the concrete sidewalks.
Sidewalks
Sidewalks will be formed and poured in Phase 1 during the week of July 4, 2022. Residents are asked to avoid driving across the new concrete sidewalks for four days to allow the concrete to sufficiently cure. Without this curing time, the new concrete is vulnerable to breaking.
Driveways
Driveways in Phase 1 will be repaved and restored the week of July 18 (subject to weather conditions).
Updated work plan and schedule
Phase 1 (south end to Foodland entrance)
- Roadway asphalt paving (June 24)
- Concrete sidewalk (week of July 4)
- Driveway asphalt paving (week of July 18 or 25)
- Turf restoration (following driveway restoration)
Phase 2 (Foodland entrance to Queen St. E)
- Asphalt and concrete removals (early July)
- Storm sewer (early July)
- Watermain and services (mid/late July)
- Road base (late July/early August)
- Concrete curb and sidewalk (TBD)
- Asphalt (TBD)
- Turf restoration (TBD)
Phase 3 (Queen St. E to Trout Creek)
- Asphalt and concrete removals (mid-August )
- Watermain and services (late August/early September)
- Road base (September)
- Concrete curb and sidewalk (late September/early October)
- Asphalt (early October)

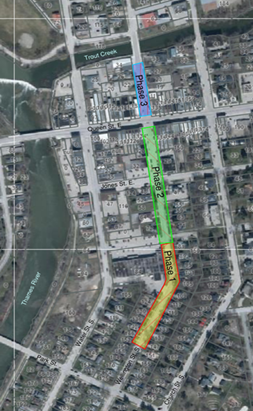

View the updated construction map to see the location of each phase.
|
|
Egan Avenue Reconstruction - Ongoing |
Project updates |
The remaining top coat of asphalt will be installed in the future. |
About the project |
Procurement: Tendered
Contractor: COPE Construction & Contracting Inc.
Cost: $1.9 million
Map of construction area
The Town has assessed the Egan Ave. reconstruction project against the current provincial legislation and determined that the project will proceed at this time.
The contractor has a policy for employees and subcontractors working during the pandemic and have enhanced measures in place following healthcare guidelines to reduce the risk of potential transmission of COVID-19 at the project site. Measures include but are not limited to:
- Physical distancing
- Personal protective equipment
- Hand washing stations on site
The Town will be reviewing the project regularly with the contractor to ensure the safety measures are adhered to.
While interacting with workers, please maintain a 2m (6 ft.) distance.
|
Project components |
The project will include:
- Watermain replacement
- Storm sewer replacement
- Sanitary sewer extension
- Sidewalk replacements and improvements
- Curb and gutter installation
- Asphalt road replacement
- Peel Street and Egan Ave. intersection improvement
|
|
Elizabeth and Waterloo Street Reconstruction - Ongoing |
Project Updates |
Week of May 18, 2022
The contractor is working on correcting turf depressions from trench settlement as well as preparing the road for final topcoat paving.
- Topsoil and seed will be placed on turf that has settled over the winter and requires leveling.
- Sewer access structures will be raised to final asphalt elevation.
- The hydrant at the end of Waterloo Street will be raised.
- Curb stops and cleanouts will be lowered to grade.
- The road will be swept and prepared for paving.
- Paving could occur as early as Friday May 20, but is more likely to occur the following week of May 24. During paving operations, driveways will be temporarily blocked as the paving equipment installs asphalt down the street.
|
About the project |
Reconstruction Areas
- Elizabeth Street from Brock Street to Waterloo Street
- Waterloo Street from Elgin Street to Sparling Bush
Project Scope
- Reconstruction of the road base with asphalt
- Installation of concrete curb and gutter
- Sidewalks
- Storm sewers and catch basins
- Replacement of water services to property line
|
Draft design and information session video
|
You can download PDF copies of the design drawings below. You can also see the design, learn more about the project and find out what to expect during construction by viewing our pre-recorded information session.
Elizabeth and Waterloo Street Reconstruction - Draft Design Drawings
Elizabeth and Waterloo Street Reconstruction - Information Session Video
Please contact us with any questions, comments or concerns.
|
|
Huron Street Sidewalk Improvements - Postponed |
Project Postponement Notice
|
At the July 27 council meeting, Council voted to postpone the Huron Street Sidewalk Improvement Project. The decision was made in order to provide residents and Council with the opportunity to review the plan and address local residents concerns such as trees, stormwater outlets, driveways and hydrants. Residents in the project area will be notified with project updates as soon as they become available.
|
About the Project |
The Town of St. Marys has made pedestrian safety a priority in recent years and invested in projects that improve the Town’s pedestrian transportation network. The Town’s 2021 capital plan includes a project to further this cause and improve the sidewalk network along the Huron Street collector road corridor from Elgin Street to Rogers Avenue. Todays Town standard includes sidewalk on both sides of collector roads to accommodate the higher pedestrian and motorized traffic on these roads. The project will bring the Huron Street road allowance up to today’s standard for Collector roads by installing sidewalk on the east side of Huron Street from Elgin Street to Rogers Avenue.
Construction Area
- Huron Street from Elgin Street E. to Rogers Avenue.
Project Scope
- Installation of sidewalks on the east side of Huron Street from Elgin Street East. to Rogers Avenue.
- Movement of a fire hydrant at corner of Huron and Elizabeth.
- Correction of hydro pole anchor wire
- Tree removals (three) in road allowance between Elizabeth St. and Rogers Avenue. As per the Towns Tree Planting Policy, nine trees will be planted in replacement of those being removed.
|
Work Schedule |
|
Service Impacts |
Impacts to the neighbourhood will be minimal. Construction crews will typically have yield to oncoming traffic control set up while working. Typical equipment noise related to excavating for sidewalk base and dust when cutting joints in the concrete. Freshly poured concrete is vulnerable to damage from vehicles. The Town asks for one week if possible to allow the concrete to cure before driving on it. Input period on preliminary design |
|
